A-500 · Progress
Rising on Riverside.
The building goes up in public. This page follows the programme, from the first pile to the keys, and is brought up to date as each stage is reached.
- Overall
- 24%
- On site now
- Frame at level 7
- Completion
- Dec 2028
- As at
- 19 Oct 2026
The programme
21 Nov 2025
Approvals granted (done)
Planning and environmental approvals for seventeen storeys and 86 homes.
13 Jan 2026
Site hoarded and cleared (done)
The plot fenced, trees marked for keeping, and the old structures taken down.
10 Feb 2026
Ground broken (done)
Work starts on the foundations.
Mar to May 2026
Piling and the basement dig (done)
Bored piles, then two basement levels dug for parking and plant.
16 Jun 2026
Ground-floor slab poured (done)
The basement is closed in and the frame can start to rise.
Jun 2026 to Apr 2027
The frame rises Under way
A floor about every eighteen days: columns, then the slab above.
Feb to Dec 2027
Façade, bays and windows
The bays go on from the bottom up, closing in each floor as the frame moves ahead.
21 Apr 2027
Topping out
The roof slab poured, seventeen storeys up.
Jun 2027 to Oct 2028
Services and fit-out
Power, water and air, then kitchens, bathrooms, floors and joinery.
16 Sep 2027
Show apartments open in the building
Viewings move from the sales suite to finished homes on level 3.
Aug to Nov 2028
Lifts, pool and gardens
Commissioning and testing, and the planting of the gardens.
16 Dec 2028
Completion
Handover of the first homes begins.
A-502 · From the site
Photographs, newest first.

10 Oct 2026 The frame passing level six, with the deck for level seven being set.

22 Aug 2026 The frame at level three, from the street.

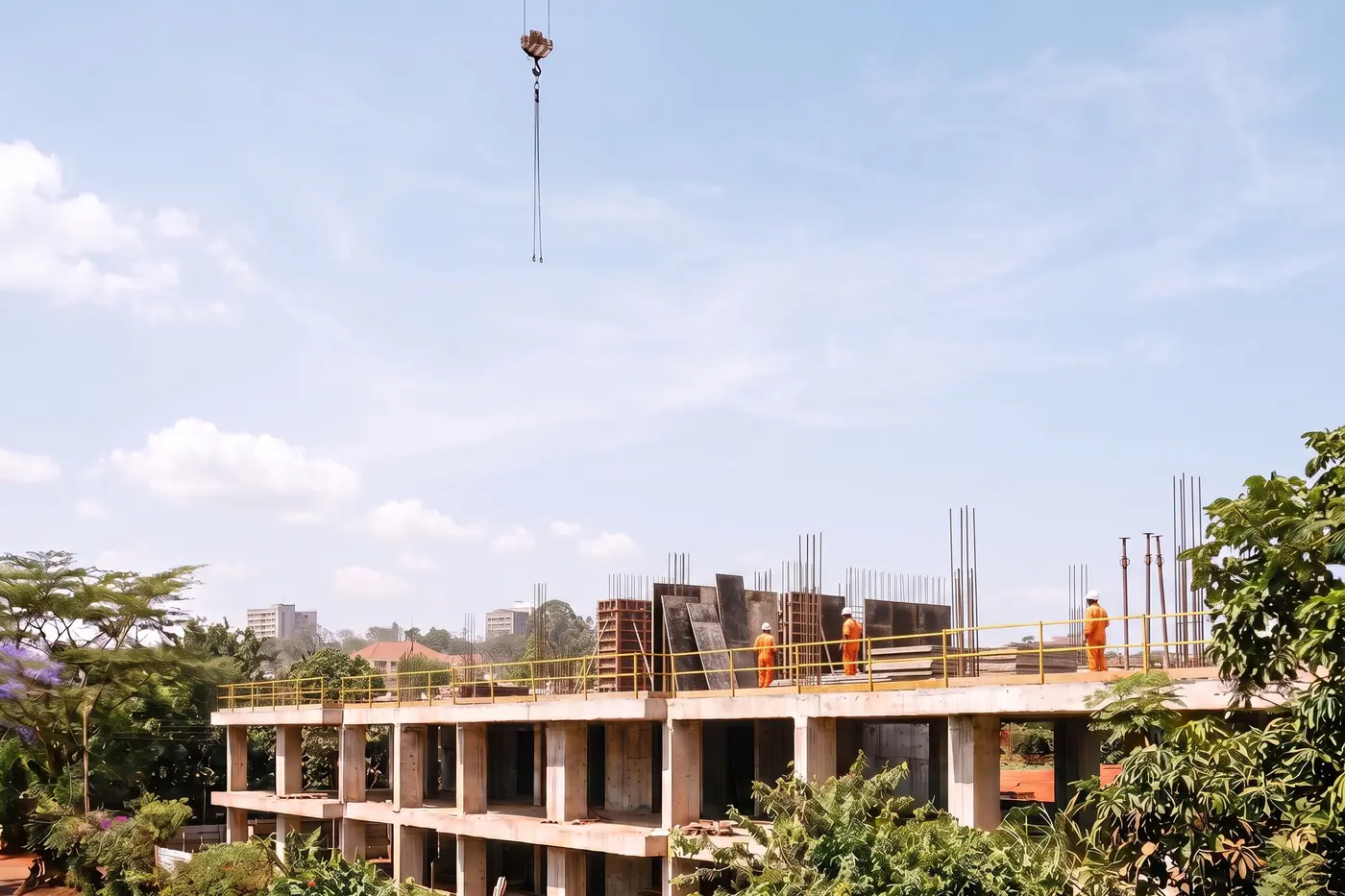

27 Jun 2026 The ground-floor slab, with the basement closed in below.
